Call a Kanban board what most teams treat it as: a status wall. Cards move left to right, someone renames a column from “Doing” to “In Review,” and the team calls the project “under control.”
Azure DevOps Boards can be that status wall. It can also be the one record that ties a work item’s ID to the commit that closed it, the pull request that reviewed it, and the pipeline stage where the change sits right now. The difference between the two comes down to a handful of decisions about process templates, backlogs, and integrations that most teams make once, by accident, in their first week, and then live with for years.
What a Work Item Record Actually Holds
A work item is a row in Azure Boards‘ data store, with a project-scoped ID, a work item type such as Bug, Task, or User Story, a set of fields, a workflow state, and a full history of every field change. That ID is what makes the rest of this post possible. Reference it in a commit message, and the platform can trace one line of code back to the reason it exists.
The Hubs Are Different Lenses on the Same Data
Azure Boards splits access to that data across a handful of hubs, and confusing them costs new users their first week. The Work Items hub gives you a flat, filterable list: items assigned to you, the ones you’re following, and anything recently updated. The Boards hub turns the same records into cards on a Kanban board, one card per item, one column per workflow state. Backlogs ranks and groups items into a hierarchy for planning. Sprints scopes that hierarchy to a single iteration and adds a Taskboard for daily standups. Queries has no dedicated card or column view of its own; it’s the filter builder that feeds the other four. Treat each hub as a different lens on the same set of records, not five separate tools with five separate datasets.
Survey data explains why teams keep reaching for a tool like this one. Ninety-nine percent of organizations already running DevOps practices report a positive effect from it, according to the self-reported survey cited in Spacelift’s DevOps market analysis, and Polaris Market Research projects the DevOps tooling market to grow at a 19.7% compound annual rate, from an estimated $10.4 billion in 2023 to $25.5 billion by 2028. That’s a satisfaction rate among adopters, not proof everyone has adopted DevOps, so treat the figure as directional, not gospel. What it tells you honestly is that “we’ll track this in a shared spreadsheet” stopped being a viable plan for most engineering orgs a while ago.
The Process Template Decision You Can’t Easily Undo
Before your first work item exists, Azure DevOps asks you to pick a process template: Basic, Agile, Scrum, or CMMI. Each one defines a different hierarchy of work item types and a different set of workflow states, and that choice shapes every backlog, board, and report you build afterward.
Basic uses a lightweight hierarchy of Epic, Issue, and Task, built for teams that want a to-do list without ceremony. Agile swaps Issues for User Stories and adds a Feature layer above them, tracking Original Estimate, Remaining Work, and Completed Work on tasks. Scrum replaces User Stories with Product Backlog Items and drops the estimate-versus-completed tracking in favor of a single Remaining Work field, matching how a burndown chart actually consumes data. CMMI adds Requirements, Change Requests, Risks, and Reviews on top of the same Epic and Feature layers, aimed at teams that need an auditable record of who approved what and when.
Why the Hierarchy Choice Is Hard to Reverse Later
None of the differences among Basic, Agile, Scrum, and CMMI are cosmetic. A Scrum board expects Product Backlog Items; if half your team keeps typing “User Story” into conversation and the other half means the same field by a different name, your queries silently miss half the work. You cannot switch a project’s base process after the fact at all: Microsoft Learn’s process template guidance linked above is explicit that the only path off a wrong template is standing up a new project on the correct one and migrating your existing work items into it. Pick based on how your team actually talks about work, not on which template sounds the most rigorous.

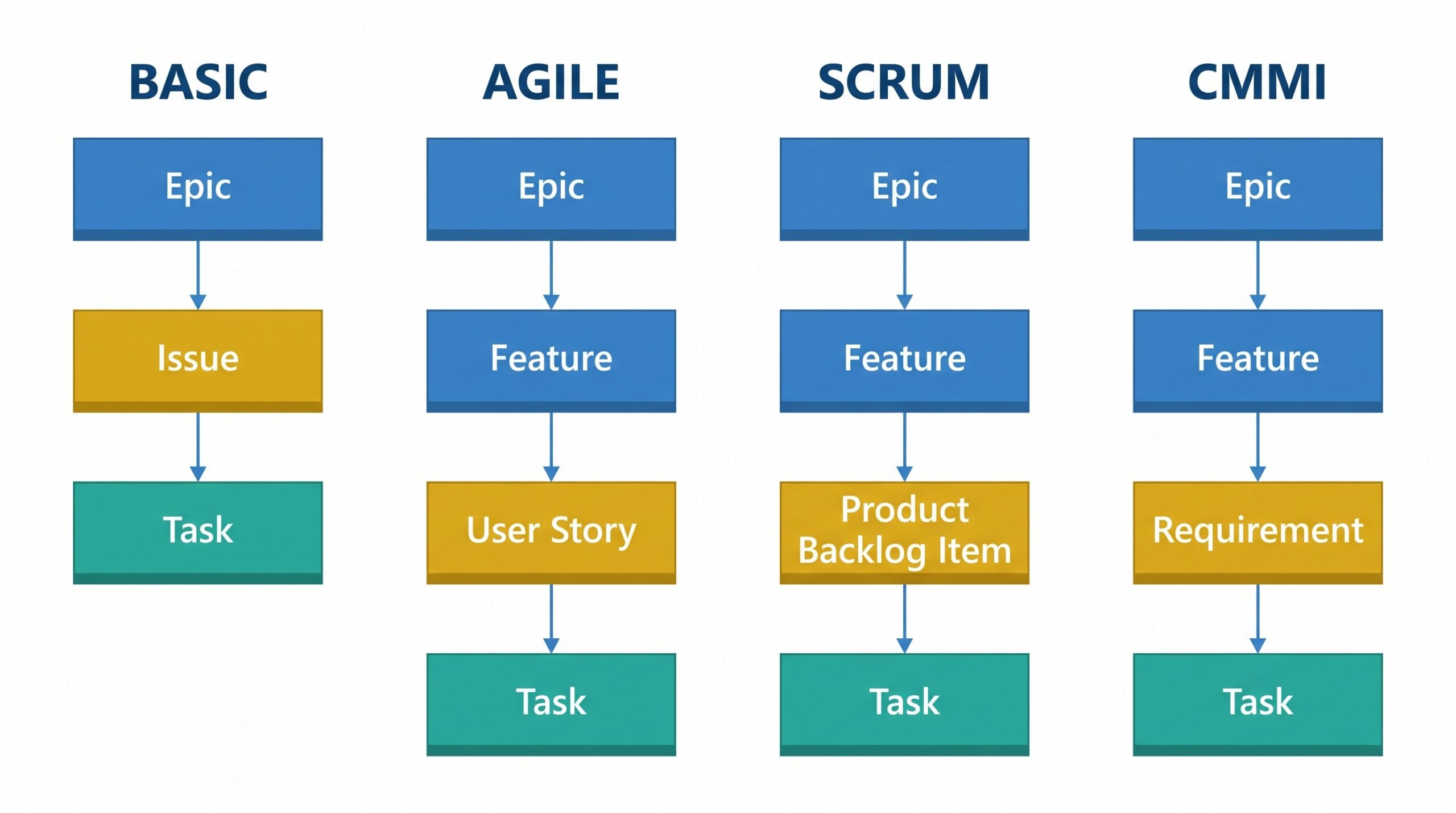

As you can see below, the four templates produce genuinely different shapes once you draw out the hierarchy side by side, which is worth doing before you commit to one.

How Portfolio Backlogs Turn a Flat List Into a Ranked Hierarchy
A flat list of a few hundred work items is unmanageable no matter how good your filters are. Portfolio backlogs solve this by nesting smaller items under larger ones: Epics group Features, Features group User Stories or Product Backlog Items, and the completion percentage of an Epic gets calculated automatically from the state of everything underneath it. That rollup is the reason product owners can report portfolio-level progress without personally opening every child item.
Rank and reparent work through the backlog view rather than editing individual work items one at a time. Drag a Feature under a different Epic when priorities shift, and every child User Story moves with it, along with its contribution to the parent’s rollup percentage.
Area Paths and the Aligned-Autonomy Trick
Large orgs don’t run one team off one backlog. Area paths let administrators assign work items to a specific product, feature area, or business unit, and assigning a distinct area path to a new team automatically gives that team its own backlog and board scoped to just its slice of the work. That’s how a single Azure DevOps organization holds dozens of independent teams without them stepping on each other, each scoped to its own area path while leadership rolls everything up to the portfolio level. Get the area path structure wrong at the start, and every team either sees too much noise from the rest of the org or gets walled off from dependencies they actually need to track.
Customizing the Kanban Board So It Reflects How Work Actually Moves
The default board columns of To Do, Doing, and Done describe almost nobody’s real process. Customize the columns to match your team’s actual states, whether that’s Design, Development, QA Review, UAT, and Deployed, or something specific to your domain. You can also split a single column into sub-columns, commonly “Doing” into “In Progress” and “In Review,” separating work someone is actively touching from work idling on another person.
WIP Limits Are a Forcing Function, Not a Suggestion
Set a work-in-progress limit on a column, and the board turns that column red the moment your team exceeds it. It’s a visible flag, not a lock: a QA Review column capped at five items still accepts a sixth card, but the red header is a standing signal that someone needs to clear the backlog before adding more. That’s the entire mechanism behind Kanban flow management, and it only works if the team actually treats red as a signal to prioritize clearing the bottleneck instead of a color they’ve learned to ignore. Skip WIP limits and the board becomes a to-do list with drag-and-drop, no different in practice from the spreadsheet it replaced.
Swimlanes add a second dimension on top of columns, most often used to carve out an expedite lane for production incidents so they stay visible without competing against routine feature work. Pair WIP limits and swimlanes with the cumulative flow diagram; a bulge in one colored band shows exactly where items are piling up, days or weeks before anyone would notice by eyeballing the board.
Closing the Loop from Commit to Deployment
None of the planning structure above matters much if it stays disconnected from the code. Connect a GitHub or Azure Repos repository to your project, and mentioning AB#{ID} in a commit message, pull request description, or issue links that artifact straight to the work item. Write “Fixes AB#123” specifically, and Azure Boards transitions the work item to its Resolved or Completed state automatically when the change merges to the default branch. Get the syntax wrong, and a stray title-only mention silently produces no link at all. Microsoft Learn’s GitHub linking guidance states it plainly: “Using AB#ID in a comment or in a pull request title doesn’t create a link on the work item.” Keep the reference inside the description body, not the PR title.
Wiring Up the Link from the Command Line
Create work items and link them to code from the command line instead of clicking through the web portal, which is worth doing the moment you’re scripting any part of your workflow. This walkthrough was verified against Azure CLI 2.80.0 with the azure-devops extension at version 1.0.2:
az boards work-item create --title "Add retry logic to the export job" \ --type "User Story" \ --project "Contoso" \ --assigned-to [email protected]
--type has to match a work item type your process template actually defines. Passing “User Story” against a project running the Scrum template fails, because Scrum expects “Product Backlog Item” in that slot. Link the resulting work item to a pull request the same way:
az repos pr create --repository Contoso --source-branch export-retry --work-items 63
Once a pipeline is configured to report deployment status back to Boards, the linked work item’s Deployment section shows which environments the change actually reached. That answers the question product managers care about: whether the change is in front of customers, distinct from whether the build merely succeeded.

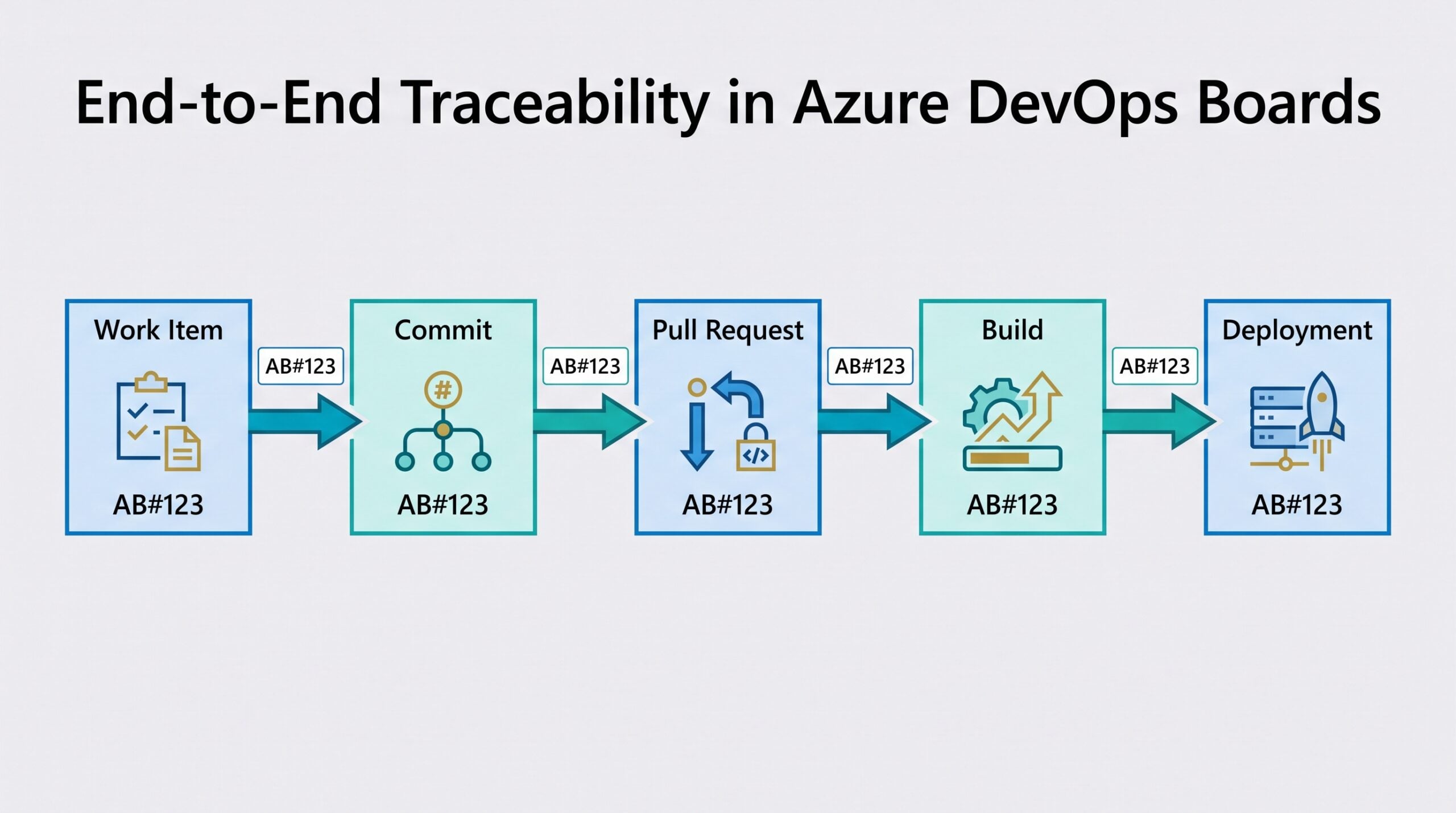

As you can see below, the finished chain runs from a single work item ID through the commit, the pull request, the build, and out to the environment where the change lands.

The Failure Modes That Cost a Sprint Its Time
A board that looks correct can still be quietly lying to you. A handful of failure modes show up often enough that they’re worth checking before you trust what a board is telling you.
Checks Worth Running Before You Trust the Board
-
Closed items still counting against a column’s WIP limit. Removed and Closed states behave differently depending on the backlog level; a closed item that isn’t hidden from a backlog view still occupies a slot other teams assume is free.
-
Backlog reordering silently failing for some users. Drag-and-drop reprioritization requires an access level above Stakeholder; a Stakeholder who thinks they moved an item up the list actually changed nothing, and nobody gets an error.
-
Multi-team ownership fights over the same items. Two teams pointed at overlapping area paths both see the same work item on their board, and both assume they own its next status change.
-
A card field edit that never saved. Stakeholder access lets you open a work item and view it, but inline card-field editing on the board itself requires Basic access or higher; the edit box closing without an error is the only symptom.
Warning: Before you hand a broad group of people Stakeholder access to “keep them in the loop,” check what that access level actually blocks. Stakeholders can view boards and backlogs and add or edit any work item within their team’s area paths, but they can’t reorder or reparent backlog items and can’t update a field directly on a card. Give a project manager who needs to reprioritize the backlog only Stakeholder access, and you’ll get a support ticket within a week asking why drag-and-drop “doesn’t work.”
Choosing a Process Template at a Glance
Weigh these trade-offs against how your workflow states and categories already map to the way your team reports progress, since that mapping is what breaks first when a template doesn’t fit.
| Template | Hierarchy | Best Fit | Watch For |
|---|---|---|---|
| Basic | Epic, Issue, Task | Small teams that want a to-do list without agile ceremony | Outgrows itself fast once a team needs sprint-level burndown tracking |
| Agile | Epic, Feature, User Story, Task | Teams running iterative delivery with estimate-vs-actual tracking on tasks | Estimate fields go stale if nobody enforces updating them during standups |
| Scrum | Epic, Feature, Product Backlog Item, Task | Teams running textbook Scrum sprints and backlog grooming | Vocabulary mismatch when team members default to saying “story” instead of “PBI” |
| CMMI | Epic, Feature, Requirement, Task | Regulated environments needing an auditable change and risk trail | Heaviest template; adds process overhead teams outside compliance-driven work rarely need |
Letting AI Query the Board Without Losing Control
The local Azure DevOps Model Context Protocol (MCP) Server changes how you interact with a board more than any UI customization does. Instead of clicking through filters to answer “what’s blocking our sprint,” ask an AI assistant in agent mode; it queries your actual Azure DevOps data through the MCP Server instead of guessing from a generic training set.
Microsoft ships both a remote and a local version of the server. The remote version needs no local installation and authenticates through Microsoft Entra ID, but only supports OAuth-capable clients such as Visual Studio Code and GitHub Copilot. Claude Desktop, Claude Code, Cursor, and Codex run the local server instead, authenticating with an Azure DevOps personal access token or Microsoft Entra ID credential and requiring Node.js 20 or later. This walkthrough used @azure-devops/mcp version 2.9.0 on Node.js v26.4.0.
Prompts Worth Trying First
Once the MCP Server is connected, practical value comes from specific, narrow prompts, not open-ended ones:
-
“Get my current sprint work items, then identify which ones might be at risk”
-
“Link work item AB#125 in project Contoso to GitHub pull request contoso/api#42”
-
“List all closed work items in project Contoso from the last 30 days that have no linked GitHub pull request”
-
“After PR contoso/api#42 merges, update linked work item AB#125 to Resolved”
Key Insight: The MCP Server retrieves data and drafts the update; it doesn’t decide policy. Bulk prompts that touch state transitions or multiple work items at once deserve the same review you’d give a scripted bulk edit, because a wrong area path or a misapplied state change against fifty items is exactly as expensive to unwind regardless of who triggered it.
Keep the Traceability Chain Honest as You Scale
The process template you pick in week one, the area paths you draw before your second team spins up, and whether you bother configuring deployment reporting on your pipeline: none of these show up as a checkbox anyone circles back to later. They’re the difference between a board that tells you the truth about where a feature actually stands and a board that just tells you where someone dragged a card.
Start with the template that matches how your team already talks about work, wire up the GitHub or Azure Repos connection before your backlog fills up with orphaned work items, and treat AI-assisted queries as a faster way to ask the board a question, one that only works if you already understand what the board is built to track. Get those three decisions right early, and the rest of this system, backlogs, sprints, dashboards, and all, keeps doing its job without anyone having to babysit it.
